Montana Department of Transportation

Malcolm “Mack” Long, Director

COVID-19

View the Governor’s Coronavirus Task Force site for more information.

Public Involvement - Active Projects

Timber Bridges Glasgow Area

Timber Bridges Glasgow Area logo

Project Overview

MDT is proactively investing in improving aging infrastructure in Montana. These actions not only safeguard the public, but they maintain Montana’s vital connections. The Timber Bridges-Glasgow Area project will replace 15 bridges in northeast Montana, impacting US 2 between Hinsdale and Glasgow, MT 24 between Glasgow and Opheim, MT 248 between Opheim and Scobey, and MT 251 between Poplar and Flaxville. The project involves replacing some of the aging and deteriorating timber bridges with new structures and will reconstruct the adjacent roadways as necessary.

Why is this project important?

The goal of this project is to keep Montana’s bridges safe, resilient, economical, and reliable. The MDT Bridge Bureau is responsible for over 5,000 bridges in the state. As an agency, they inspect, evaluate, replace, rehabilitate, and preserve structures under their jurisdiction.

The aging timber structures are deteriorating and have limited serviceable life remaining. MDT has determined that the most cost-effective approach is to replace the bridge bundle through a Design-Build contract.

What does this mean to me?

The design phase means this is your chance to provide us information and points of view that are important to how you and your communities use these bridges and the roadways connected to them. Working together, we will have opportunities for you to provide input as we develop our plans for each bridge.

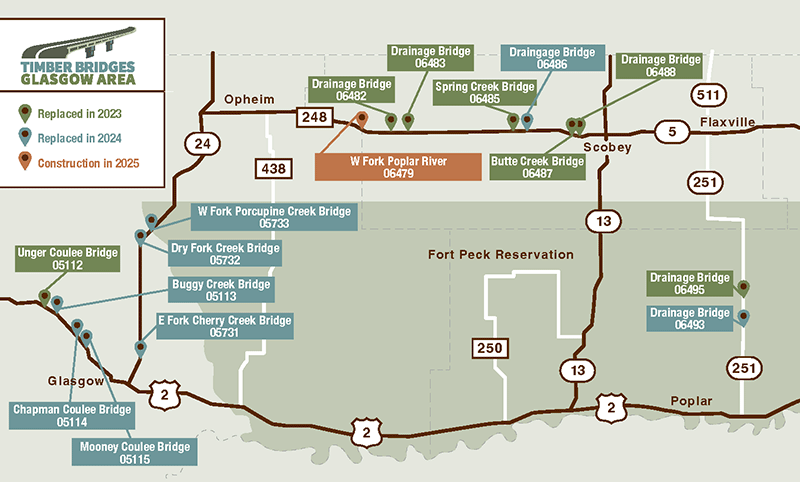

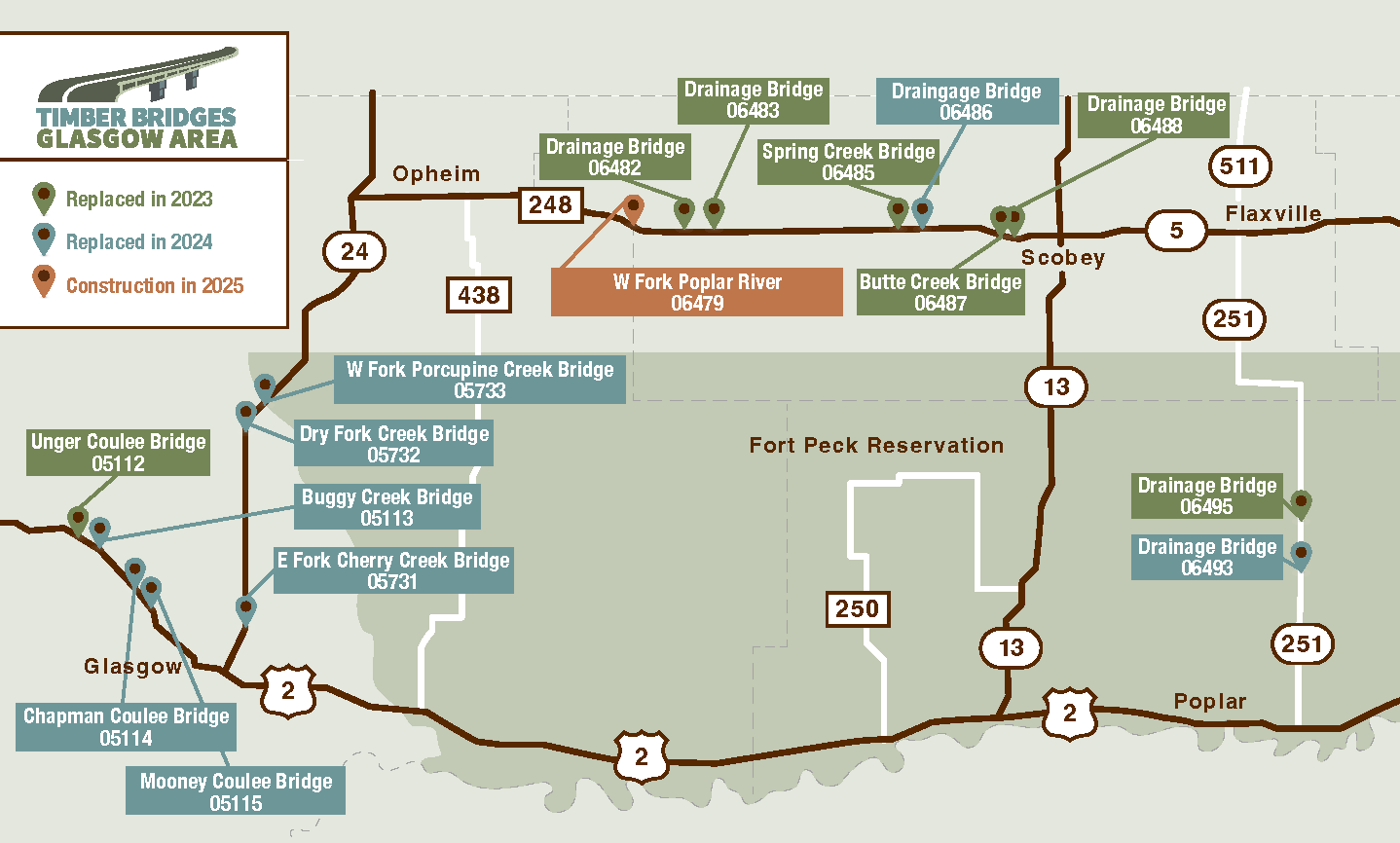

Bridge List 

MDT Structure ID Feature Intersected Location Route Ref Post County
05112 Unger Coulee 14mi NW GLASGOW US 2 527.0 VALLEY
05113 Buggy Creek 12mi NW GLASGOW US 2 528.2 VALLEY
05114 Chapman Coulee 7mi NW GLASGOW US 2 533.5 VALLEY
05115 Mooney Coulee 6mi NW GLASGOW US 2 534.3 VALLEY
05731 E Fork Cherry Creek 6mi N GLASGOW MT 24 6.3 VALLEY
05732 Dry Fork Creek 25mi SW OPHEIM MT 24 25.2 VALLEY
05733 W Fork Porcupine Creek 18mi S OPHEIM (North end on Fort Peck Indian Reservation) MT 24 28.0 VALLEY
06482 Drainage 5mi E RICHLAND MT 248 21.9 DANIELS
06483  Drainage 7mi E RICHLAND MT 248 23.7 DANIELS
06485 Spring Creek 2mi W FOUR BUTTES MT 248 35.6 DANIELS
06486 Drainage 0.5mi W FOUR BUTTES MT 248 37.0 DANIELS
06487 Butte Creek 3mi W SCOBEY MT 248 42.8 DANIELS
06488 Drainage 2mi W SCOBEY MT 248 43.1 DANIELS
06493 Drainage 20mi NE POPLAR (On Fort Peck Indian Reservation) MT 251 15.5 ROOSEVELT
06495 Drainage 25mi NE POPLAR (On Fort Peck Indian Reservation) MT 251 20.7 ROOSEVELT

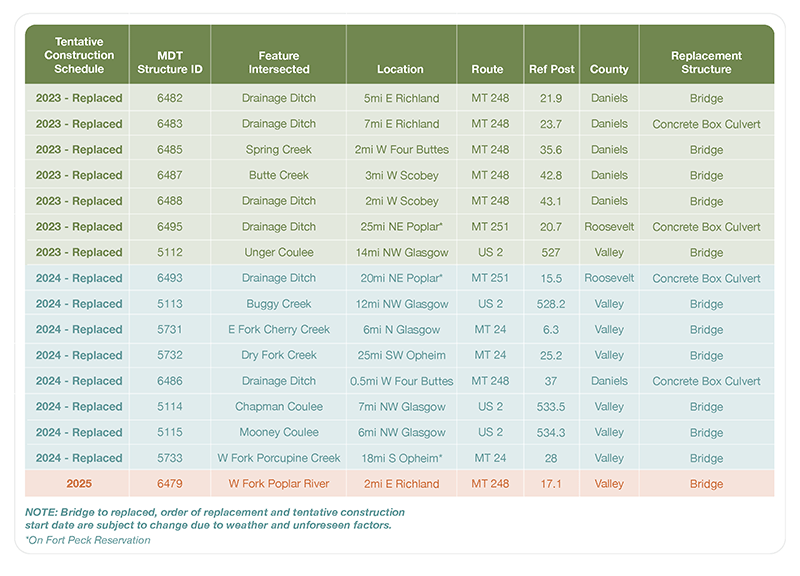

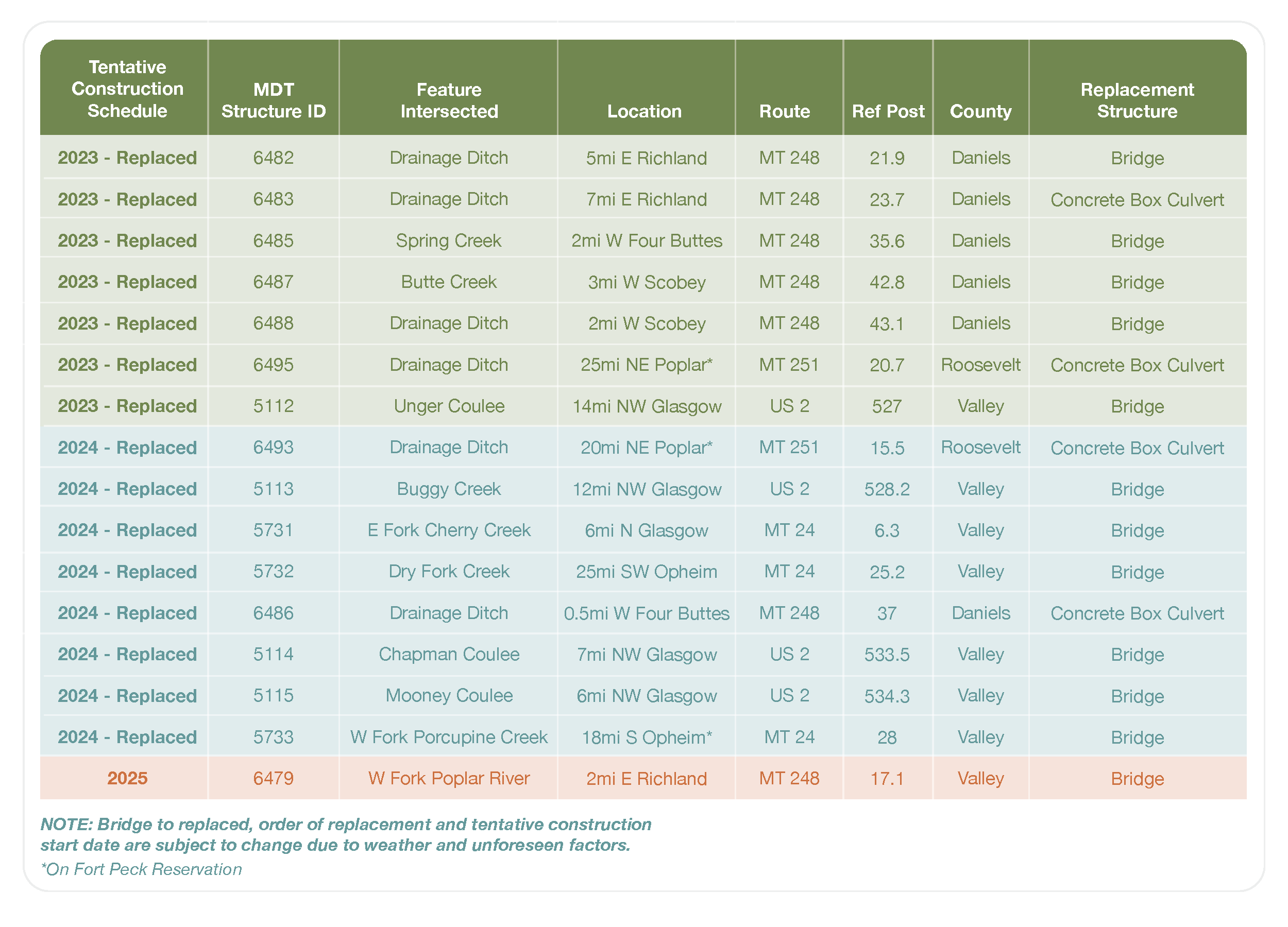

Process and Anticipated Schedule 

Phase 1 Preliminary Design – October 2020 – September 2021

  • Gather preliminary information at each bridge site
  • Develop reasonable solutions for replacing the existing bridges
  • Provide MDT with a summary of all information gathered
  • MDT to solicit Design Build Request for Proposals in Fall 2021

Phase 2 Final Design and Construction – October 2021 – Fall 2023

  • Design-Build Team will develop final construction plans by Spring 2022
  • Design-Build Team will perform construction from Spring 2022 – Fall 2023

Project Cost

Preliminary cost estimates are being developed as part of the Phase 1 Preliminary Design. 

Engineer to English 

Phase 1 Preliminary Engineering – Phase 1 services are needed to understand and analyze the project, as well as formulate design for all sites. The information provided through the Phase 1 analysis will be utilized in the Design-Build process. Phase 1 will provide numerous investigation, analysis, and design services, including: surveys; hydraulic analysis; geotechnical exploration; environmental investigation; concept roadway and bridge design; public involvement; cost estimation and risk analysis; traffic management and construction phasing recommendations; R/W design, and potentially R/W acquisition.

Design-Build – A project delivery system that combines the design and construction services for a project into a single contract. Teamwork between the design engineer and contractor helps project teams to develop better solutions, reduce project costs, maintain quality, and expedite project delivery. The process for Design-Build projects is different from MDT’s typical project development approach; however, all work is completed in accordance with state and federal design standards, specifications and contract administration practices. Design-Build can be a helpful tool for completing unique and challenging projects like this one!

Stay Involved

Public involvement is important to MDT and the success of the project. The community will be notified about public involvement opportunities through this website, local media, mailings, social media channels and other means as the project progresses.  MDT encourages questions and comments about the project. You can submit them through the MDT Comment page or directly to our team here.

UPN 9885
